Integrated Project Management and BIM for Architecture Firms: From Concept to Construction Without Surprise

Project volatility, missed deadlines, budget drift, unexpected RFIs, and drawing-set inconsistencies - most often emerge at phase transitions and coordination boundaries. Below we’ll outline an integrated project management framework for architecture teams that links phase-gate discipline, BIM coordination, structured decision management, and measurable KPIs to produce more predictable outcomes from Schematic Design through Construction Administration.


The Variance Problem in Architectural Delivery

Project surprises rarely materialize “all at once.” They accumulate gradually through unclear scope, delayed decisions, and under-coordinated consultant documentation. Research and industry guidance from sources such as the AIA Best Practices (https://www.aia.org/resource-center/best-practices-enhancing-drawings-specifications) and DBIA Best Practices (https://dbia.org/) confirm that the root causes cluster into three categories:


  • Incomplete or unverified scope at phase milestones

  • Poorly coordinated consultant models and sheets

  • Decision latency from owners and stakeholder committees


Left unaddressed, these lead to downstream RFIs, costly ASIs, schedule slippage, and can cause mistrust between parties.


ree

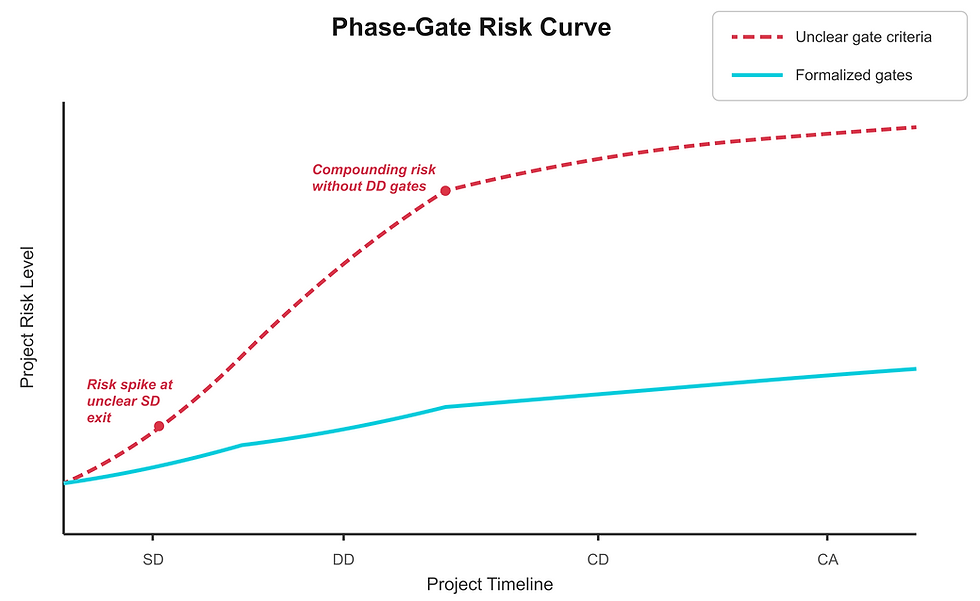

Figure 1 - Phase-Gate Risk Curve (Conceptual)

(Description: A line graph showing risk increasing sharply when SD or DD exit criteria are unclear, then flattening when gates are formalized and checked.)


Phase-Gate Discipline with Explicit Exit Criteria

The first pillar of predictable project delivery is formalized phase-gates - not as bureaucracy, but as a means of preventing silent scope expansion and undocumented assumptions.


Recommended Gate Checklist Items:

  • SD Gate: verified program, initial code path, orientation strategy, target cost alignment

  • DD Gate: coordinated MEP/structural layouts, preliminary wall sections, code and life safety compliance checks

  • CD Gate: constructable details, model-to-sheet consistency, spec alignment



Sidebar — Example Gate Language:

“DD may not close until Life Safety, Code Summary, and MEP riser align without unresolved conflicts.”


Gate outcomes should be logged and archived, not treated as informal conversations.


BIM as the Coordination Backbone

If phase-gates are the structure, BIM is the mechanism that enforces coordination quality. Integrated delivery requires:


  1. Federated models - not consultant silos

  2. Clash rules and audit routines - weekly is best practice

  3. LOD (Level of Development) clarity using AIA documents

    1. https://learn.aiacontracts.com/articles/6469008-so-what-is-an-lod-anyway/

  4. Internal Model health management - warnings, file size, ownership of views and sheets


ree

Figure 2 - Weekly BIM Workflow (Conceptual)

(Description: Model Audit → Clash Review → Issue Assignment → Coordination Call → Close Loop)




Decision Management and Owner Communication

Late decisions cost exponentially more to resolve than early ones. To counter this:


  • Use a Decision Log with impact tags (schedule, cost, drawing revisions)

  • Establish decision deadlines by phase, and within phases, not open-ended review cycles

  • Assign accountability using RACI matrices (Responsible, Approver, Consulted, Informed)


Sidebar — Sample Decision Log Fields:

Decision | Owner | Due Date | Affected Sheets | Impact | Status


A project without a decision log is relying on memory, not management.


Constructability and Cost Alignment Early

Constructability should not wait until CA. To reduce rework:



  • Integrate the Construction Manager/General Contractor or Cost Estimator in DD whenever possible

  • Use target value design approaches from the Lean Construction Institute

  • Resolve detailing conflicts in Model-Based sections before CDs



This reduces RFIs and gives owners cost clarity without scope erosion.



Measured Outcomes: KPIs for Architecture Delivery

To improve something, it must be measurable. Useful KPIs include:


KPI

Target

RFI density (RFIs / sheet count)

Low and trending down

Addenda count

Minimal, especially after DD

Coordination cycle time

7 days or less

Change orders tied to design ambiguity

Zero is ideal


ree

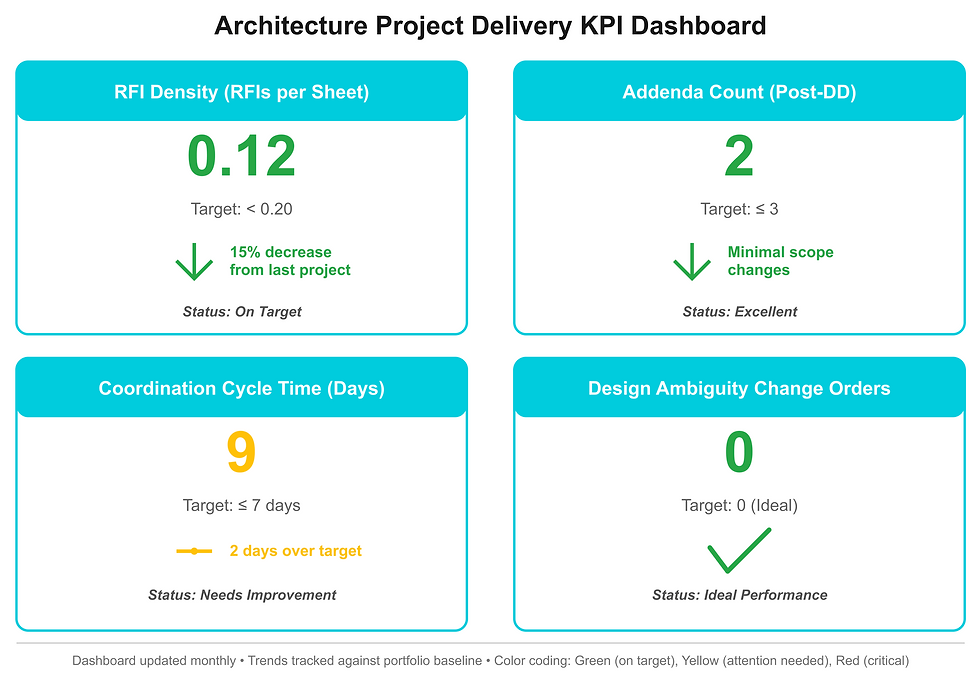

Figure 3 - KPI Dashboard (Conceptual)

(Description: A four-metric grid showing trend arrows and thresholds for each KPI)



Feedback loops should continue into post-occupancy learning, informing the next project and building a standards library.


Conclusion

Integration - across phases, models, decisions, and metrics - is the differentiator between reactive project delivery and proactive control. While no process eliminates all uncertainty, an integrated PM framework reduces variance, improves consultant cohesion, and builds trust with owners and contractors.



For templates (Decision Logs, Gate Checklists, or BIM Issue Trackers), Brink Design can provide project-specific tools upon request.
